BHAVYA Scheme: Can Plug-and-Play Industrial Parks Transform Manufacturing?

Ready-built industrial sheds compress factory gestation timelines, but structural power, freight, and labor rigidities test the BHAVYA scheme's promise.

Changes In Industrial Policy And Effects On Industrial GrowthInfrastructure: Energy, Ports, Roads, Airports, Railways Etc.Investment ModelsGovernment Policies And Interventions For Development In Various Sectors

Oct, 2026

•

9 min read

Plug-and-play manufacturing parks combine standard factory sheds and dedicated utility hook-ups to compress project gestation timelines.
Plug-and-play manufacturing parks combine standard factory sheds and dedicated utility hook-ups to compress project gestation timelines.

Context

The Union Cabinet approved the Bharat Audyogik Vikas Yojna (BHAVYA) with an outlay of ₹33,660 crore over six years. The initiative aims to build 100 plug-and-play industrial parks across India. It compresses gestation periods from years to months using ready-built sheds and pre-cleared clearances.

Yet physical shells cannot succeed in isolation. The scheme converts front-loaded capital outlays into operating leases. That shift hinges on state-level factor-market reforms. Ready infrastructure cannot independently offset heavy commercial power cross-subsidies, fragmented labour inspections, and elevated rail freight tariffs that stranded capital in legacy estates.

Why in the News? The Rollout of the BHAVYA Scheme

The Union Cabinet approved the Bharat Audyogik Vikas Yojna (BHAVYA) as a flagship national initiative to transform industrial manufacturing infrastructure across Indian states. The rollout operationalises the policy intent announced in the Union Budget 2024–25, which earmarked the development of plug-and-play parks in or near 100 cities in partnership with states and the private sector.

Key pillars of the programme rollout include:

  • Targeted capital grants: Central assistance provides up to ₹1 crore per acre for park sizes ranging from 100 to 1,000 acres, with a reduced threshold of 25 acres for Northeastern and Himalayan states.
  • Competitive state allocation: Phase I will select up to 50 parks through two competitive bidding rounds that evaluate states on regulatory reform readiness, land contiguity, and multi-modal connectivity.
  • Dedicated chemical hubs: The Cabinet sanctioned the BHAVYA-Rasayan sub-scheme to build three dedicated Chemical Parks with central grant assistance of up to ₹1,000 crore per park.

Discuss with Superkalam

What is the maximum central grant per acre provided under the general guidelines of the BHAVYA scheme?

Ask Now

What is the BHAVYA Scheme and the Plug-and-Play Model?

The plug-and-play industrial model provides ready-built standard design factory sheds equipped with pre-cleared statutory clearances, underground utility conduits, and shared effluent treatment systems. Incoming manufacturers install machinery and start production immediately, skipping protracted land-acquisition cycles and zoning clearances.

As of October 2026, the India Industrial Land Bank (IILB) mapped over 4,160 industrial parks, demonstrating that raw land availability is not the primary barrier holding back manufacturing growth. Rather, the bottleneck lies in the prolonged friction of transforming undeveloped plots into operational shop floors. Medium- and high-technology sectors account for 46.3 percent of India's manufacturing value addition, demanding specialised testing labs, steady power, and advanced waste management.

Feature / Dimension Conventional Industrial Estate BHAVYA Plug-and-Play Park
Allotment Nature Raw or semi-developed land plots Ready-built standard factory sheds
Gestation Timeline 24 to 48 months for construction and approvals Compressed from years to months
Regulatory Clearances Tenant navigates independent state line departments Pre-cleared statutory approvals provided at park entry
Off-Site Connectivity Often uncoordinated; last-mile hook-ups delayed Up to 25% of central funds permitted for off-site rail-road links
Common Amenities Basic access roads, open drainage Testing labs, skill centres, worker dormitories

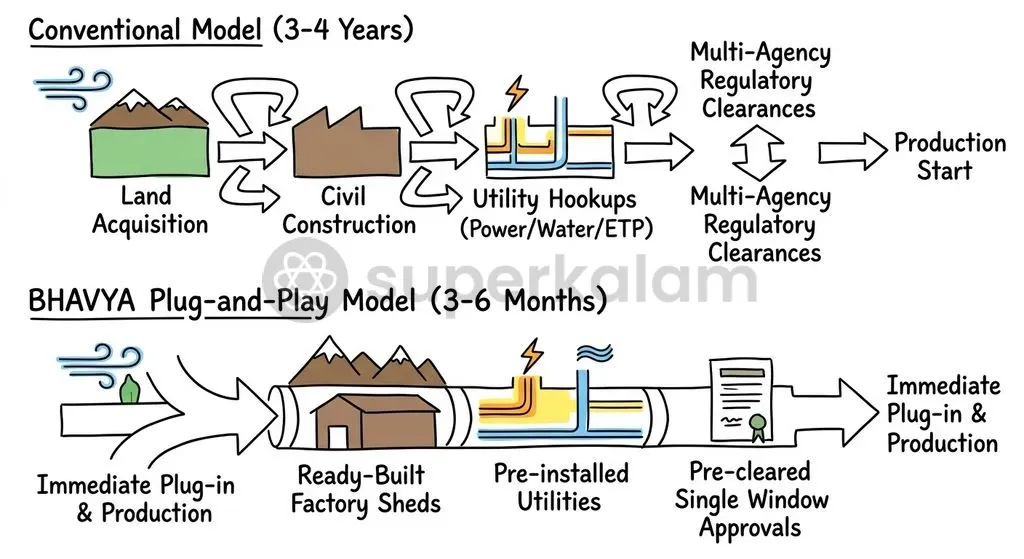

The plug-and-play approach eliminates sequential construction and regulatory delays by preparing pre-cleared industrial shells.
The plug-and-play approach eliminates sequential construction and regulatory delays by preparing pre-cleared industrial shells.

The Strategic Promise: How Ready-Built Sheds De-Risk Greenfield Investment

Greenfield capital expenditure carries severe front-loaded risks for micro, small, and medium enterprises (MSMEs) and foreign direct investors entering unfamiliar sub-national markets. According to the Economic Survey 2023–24, ready-built factory sheds de-risk investment by converting upfront capital outlays into manageable operational expenditures via long-term lease arrangements.

This conversion enables prospective manufacturers to conserve liquid capital for core working needs:

  • Capital allocation efficiency: Firms allocate scarce equity towards precision tooling, robotics, research, and workforce onboarding rather than immobilising capital in dead earth and brickwork.
  • Compressed market-entry cycles: Exporters targeting transient global demand cycles can set up production lines rapidly, avoiding multi-year site approvals.
  • Shared ecosystem infrastructure: The BHAVYA framework covers specialised testing labs, common certification facilities, and shared effluent management that individual MSMEs cannot finance alone.
  • Workforce welfare assets: Eligible guidelines provide funding for on-site skill development units and worker dormitories to support gender-inclusive workforce participation in assembly corridors.

Discuss with Superkalam

How does shifting from greenfield land purchase to leased ready-built factory sheds alter the balance sheet risks for an MSME?

Ask Now

Lessons from the Past: Why SITP and Electronics Clusters Stalled

The Scheme for Integrated Textile Parks (SITP) offers a sobering historical precedent for capital-heavy infrastructure projects. A performance audit by the Comptroller and Auditor General (CAG) revealed that legacy SITP projects achieved only 37 percent of target units and 30 percent of projected employment, with 43 percent of all sanctioned parks eventually cancelled.

Past cluster programmes faltered because physical construction outpaced practical industrial demand:

  1. Remote geographic placement: Parks were frequently sited on peripheral, cheap land lacking natural industrial density or freight links.
  2. Stranded common facilities: The Ministry of Electronics and Information Technology formulated Modified Electronics Manufacturing Clusters (EMC 2.0) with support up to ₹50 crore per 100 acres because EMC 1.0 faced low tenant absorption from inadequate common facility centres.
  3. Flawed developer incentives: Special purpose vehicles (SPVs) under SITP often prioritised real-estate development margins over the long-term operational health of tenant manufacturers.

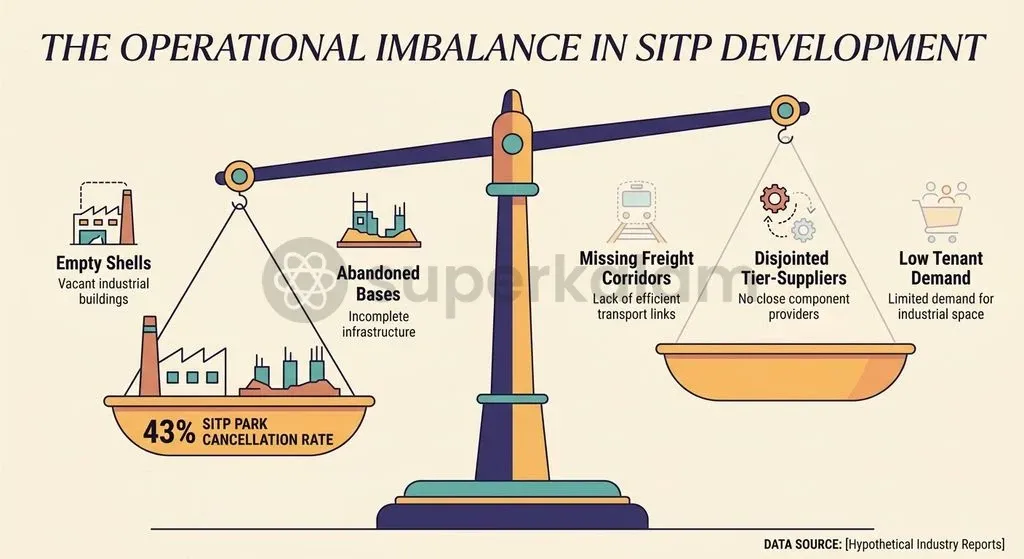

Historical evaluations show that industrial parks face high cancellation and under-occupancy when disconnected from real supply networks.
Historical evaluations show that industrial parks face high cancellation and under-occupancy when disconnected from real supply networks.

The Unresolved Bottlenecks: Land, Labor Laws, and Power Tariffs

Factor market rigidities remain the decisive barrier that ready-built physical factory shells cannot unilaterally solve. Manufacturing enterprises in most states remain subject to over 1,000 regulatory compliance obligations and repetitive inspectorate visits across labour, boiler, and environmental legislations.

Factor Dimension Structural Distortion Direct Operational Impact
Power Tariffs 25–55% mark-up above cost of supply High cross-subsidies penalise energy-intensive manufacturing
Labour Compliance Over 1,000 compliance obligations Overlapping state inspectorates create sustained regulatory drag
Freight Pricing Elevated rail freight tariffs Cross-subsidisation of passenger travel inflates inland freight rates

The underlying structural hurdles encompass three primary factor areas:

  • Distorted power pricing: Indian industrial consumers pay electricity tariffs that are 25 to 55 percent higher than the average cost of supply due to state-mandated cross-subsidisation of agricultural and domestic feeders. This places energy-intensive manufacturing at a major disadvantage against regional competitors like Vietnam.
  • Deemed clearance friction: Operational audits of the National Single Window System (NSWS) show that deemed statutory approvals are frequently impeded by state line departments asserting independent rights under municipal and town-planning bye-laws.
  • Freight tariff penalties: India's railway pricing imposes artificially elevated freight rates on key industrial commodities to cross-subsidise unremunerative passenger travel. This erodes the logistical viability of operating inland industrial hubs.

Discuss with Superkalam

If you were designing a competitive state bidding proposal under Phase I of BHAVYA, how would you address multi-modal logistics and land contiguity?

Ask Now

Global Benchmarks: How Vietnam and East Asia Scaled Ready-Built Zones

The Vietnam-Singapore Industrial Park (VSIP) joint-venture model demonstrated how plug-and-play infrastructure must integrate with surrounding trade administrative systems. According to World Bank case studies, VSIP hubs secured rapid tenant occupancy by co-locating multi-tiered global component suppliers alongside on-site provincial customs desks and single-window administrative teams.

East Asian industrial hubs tackled spatial fragmentation directly. China's industrial townships across the Pearl and Yangtze River Deltas, including Kunshan and Shenzhen, enforced an aggressive one-hour supply chain cluster rule. This spatial planning mandate required tier-2 and tier-3 component makers to sit within immediate trucking distance of anchor assembly plants. By pairing standard factory sheds with tight local supply chain density, these hubs eliminated buffer inventory costs for global value chains.

Benchmark Model Core Operational Strategy Regulatory & Administrative Integration Primary Value Proposition
Vietnam-Singapore Industrial Parks (VSIP) Multi-tiered supplier co-location within integrated zones On-site customs desks and provincial administrative single windows Seamless border clearance and immediate supplier matching
Chinese Industrial Townships (Kunshan/Shenzhen) Mandatory 'one-hour supply chain cluster' radius Integrated municipal zones combining housing, factories, and utility substations Elimination of logistics transit buffers for tier-2/3 inputs
India BHAVYA Parks Ready-built standard sheds with central funding up to ₹1 crore/acre Linked with PM Gati Shakti GIS platform and state-level single windows De-risking greenfield entry and compressing gestation timelines

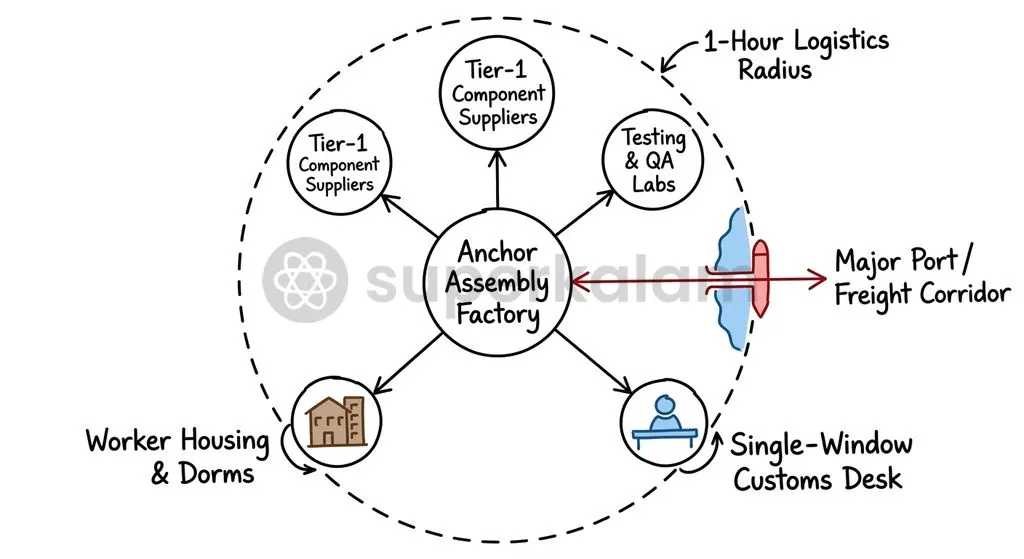

East Asian manufacturing zones thrive on rapid proximity between tier-1 assembly hubs and lower-tier component makers.
East Asian manufacturing zones thrive on rapid proximity between tier-1 assembly hubs and lower-tier component makers.

Way Forward: Moving from Physical Shells to Full Ecosystem Competitiveness

The National Industrial Corridor Development Programme (NICDC) and the BHAVYA framework must treat ready-built sheds as the starting point rather than the final measure of industrialisation. To prevent newly built parks from turning into under-utilised concrete shells, central and state authorities must implement several targeted interventions.

A sustainable industrial park strategy requires coordinating physical space with broader policy levers:

  1. Mandatory GIS integration: Implementing the BHAVYA guideline requirement to tie park boundaries directly into the PM Gati Shakti National Master Plan ensures multi-modal rail and road links are operational before tenant allotment.
  2. Utilising off-site funding provisions: State agencies should fully utilise the provision permitting up to 25 percent of central funding for external connectivity and last-mile utility connections.
  3. True administrative single windows: State governments must amend local town-planning and municipal statutes to legally enforce deemed approvals granted through the National Single Window System, preventing unauthorised secondary line-department inspections.
  4. Rationalised industrial power structures: State electricity regulatory commissions must establish dedicated, open-access industrial feeder zones within BHAVYA parks to limit high cross-subsidy surcharges.
  5. Specialised sub-scheme execution: Expediting chemical park development under the ₹1,000 crore grant assistance provision of BHAVYA-Rasayan can anchor critical intermediate raw-material supply chains on domestic soil.

Discuss with Superkalam

Compare the reasons behind the partial failure of the SITP with the current design safeguards incorporated into the BHAVYA scheme.

Ask Now

Key Takeaways

  • The Union Cabinet approved the BHAVYA scheme with a ₹33,660 crore outlay across FY 2026–27 to FY 2031–32 to establish 100 plug-and-play industrial parks.
  • Financial assistance provides up to ₹1 crore per acre for parks between 100 and 1,000 acres, with up to 25 percent earmarked for off-site rail-road and utility connectivity.
  • Ready-built sheds convert heavy greenfield capital expenditure into operational lease outlays, helping MSMEs and foreign direct investors compress gestation cycles.
  • Past schemes like the Scheme for Integrated Textile Parks (SITP) suffered from low tenant absorption, with CAG reporting that only 37 percent of target units were achieved and 43 percent of parks were cancelled.
  • Physical infrastructure alone cannot resolve structural factor market rigidities, such as industrial power tariffs that sit 25 to 55 percent above the cost of supply and extensive sub-national compliance obligations.

Mains Question

"Physical shells cannot independently succeed in isolation when legacy factor-market distortions remain unaddressed." In the context of the Bharat Audyogik Vikas Yojna (BHAVYA), critically analyse how deep-seated factor market distortions impede the transformation of India's manufacturing sector. (15 Marks)

Evaluate Now
